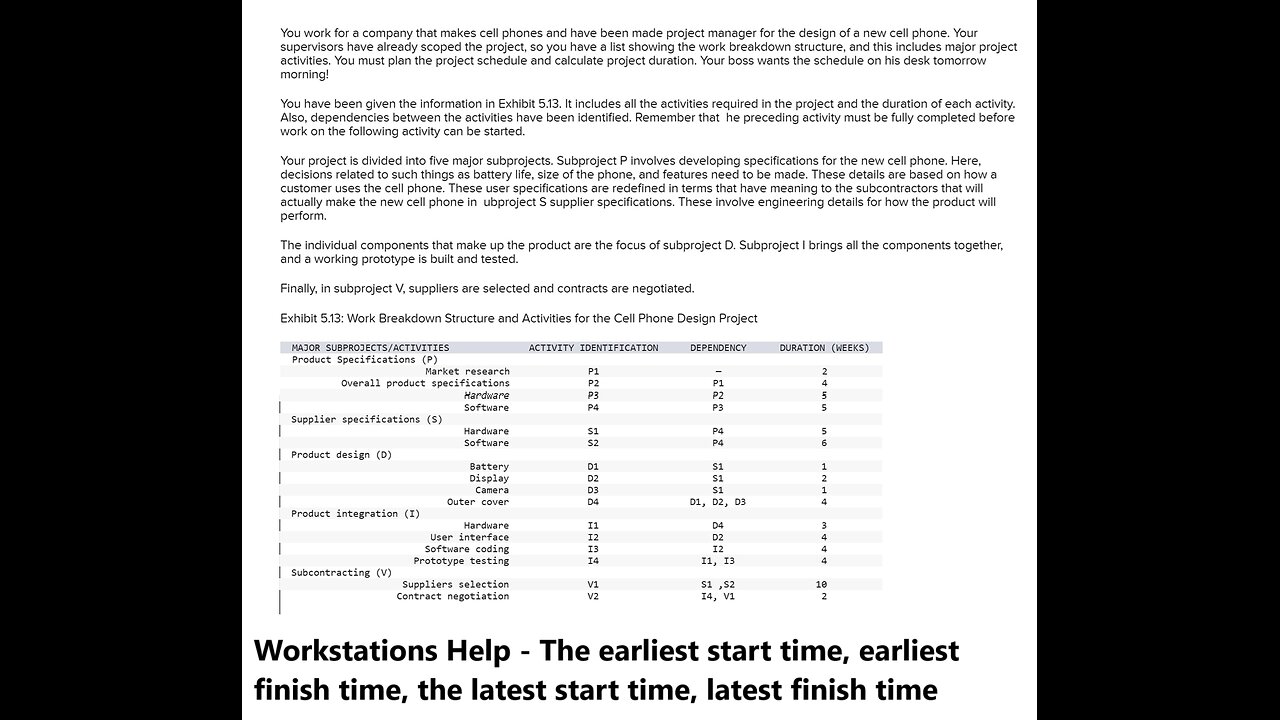

You work for a company that makes cell phones and have been made project manager for the design of a new cell phone. Your supervisors have already scoped the project, so you have a list showing the work breakdown structure, and this includes major project activities. You must plan the project schedule and calculate project duration. Your boss wants the schedule on his desk tomorrow morning! You have been given the information in Exhibit 5.13. It includes all the activities required in the project and the duration of each activity. Also, dependencies between the activities have been identified. Remember that the preceding activity must be fully completed before work on the following activity can be started. Your project is divided into five major subprojects. Subproject P involves developing specifications for the new cell phone. Here, decisions related to such things as battery life, size of the phone, and features need to be made. These details are based on how a customer uses the cell phone. These user specifications are redefined in terms that have meaning to the subcontractors that will actually make the new cell phone in subproject S supplier specifications. These involve engineering details for how the product will perform. The individual components that make up the product are the focus of subproject D. Subproject I brings all the components together, and a working prototype is built and tested. Finally, in subproject V, suppliers are selected and contracts are negotiated. AAAA S2 Exhibit 5.13: Work Breakdown Structure and Activities for the Cell Phone Design Project MAJOR SUBPROJECTS/ACTIVITIES ACTIVITY IDENTIFICATION DEPENDENCY DURATION (WEEKS) Product Specifications (P) Market research P1 Overall product specifications P2 Hardware P3 Software Supplier specifications (S) Hardware Software P4 Product design (D) Battery Display Camera Outer cover D1, D2, D3 Product integration (I) Hardware D4 User interface D2 Software coding 12 Prototype testing 11, 13 Subcontracting (V) Suppliers selection si ,S2 Contract negotiation 14, vi a. Calculate the start and finish times for each activity. (Leave no cells blank - be certain to enter "O" wherever required.) Answer is complete but not entirely correct. Activity Earliest Start Time 0 Earliest Finish Time | Latest Finish Time 2 P1 2 P2 20 P3 P4 11 16 S1 S2 D1 D2 D3 D4 16 21 210 210 6 11 16 21 22x 23 X 22 24 X 27 30X 27 31 35 32 37 Latest Start Time 0 2 6 11 16 19 X 22 X 23 X 21 24 X 28 X 23 27 31 25 X 35 11 16 21 25 X 24 X 24 248 28 X 31 27 31 35 35 37 23 12 13 14 27 23 27 31 22X 35 V2

#Workstations
#Productions
#Operations
#TheEarliestTime
#TheLatestTime
#SupplyChainManagement

Loading comments...
